Define operating hours

A roster defines how a resource (e.g. a piece of equipment) uses time throughout the week. It acts as an operational schedule, determining when the resource is available to perform scheduled tasks – and when it isn’t. Scheduled tasks can be performed during available operating time, while other types of tasks (like breaks) occur during non-operating time.

A resource can perform two types of tasks:

In XECUTE, you can build rosters – allocating productive and non-productive time throughout the week. You assign a resource (e.g., piece of equipment) to a roster to determine its operational schedule.

You build a roster by allocating productive and non-productive hours across each day of the week. The roster breaks time into intervals (hourly, half-hourly, 15-minute, or 5-minute blocks). Non-productive hours grouped into user-defined work categories, such as Shift Change, Weekend, or Blast Delay. A roster repeats on a weekly cycle.

Open operating hours setup

Setting up operating hours primarily involves defining work categories and rosters.

How to define a resource’s operating hours

To define a resource’s operating hours

  1. Set up work categories.

    1. Go to Config > System Management > Work Categories.

    2. Create a work categories, defining types of non-productive time used in a roster.

  2. Set up rosters.

    1. Go to Config > System Management > Rosters.

    2. Create a roster, and assign work categories to time intervals across each day of the week.

  3. Assign a resource to a roster.

    1. Go to Config > System Management > Resources.

    2. Select a resource then, using the Roster property, select the required roster.

Work categories

A work category represents a type of task.

There are two system-defined categories:

Default Category

Type

Description

Available

Productive

Time when the resource is available to perform productive tasks (i.e., digging, drilling…).

Maintenance

Non-productive

Time allocated for maintenance, during which the resource is unavailable.

You can define additional non-productive work categories to represent other types of downtime, such as:

Only non-productive categories can be user-defined. Productive time is always represented by the Available category.

Create work categories

You define a list of work categories in Config > System Management > Work Categories.

Use the options to add , remove , and save work categories.

Properties

After you create a work category, you need to define its properties.

Work Category

Name

Defines the name of the work category.

Display Colour

Defines the colour of the work category as it appears as a task bar on the Gantt chart.

Priority

Determines which category is shown when multiple non-productive events overlap. Lower numbers = higher priority.

Assign work categories

Each roster is made up of time intervals: blocks of time that represent either working or non-working periods. Every block is assigned a work category, which determines whether the resource can perform scheduled tasks during that time.

The table below shows how the first six hours of each day might be structured using half-hour intervals. Each cell represents a time block that can be assigned a work category.

You can customise the operating time however you like. For example:

Process

To assign work categories

  1. Choose a time interval to select the level of detail you want to work with (e.g., hourly, 15-minute, 5-minute).

  2. Select a work category from the list of available categories (e.g., Available, Break, Maintenance).

  3. Click or drag across time blocks I the roster to assign the selected category.

  4. As needed, reassign blocks by selecting a different category and clicking again.

  5. Save your changes.

You can use the ellipsis menu to quickly create new work categories . You can also use the Set All button to apply the selected category to all blocks in the roster.

Multiple rosters

You can define multiple rosters in XECUTE, each tailored to the operating pattern of a specific resource or group of equipment. This allows you to reflect differences in availability across your fleet.

For example:

Each resource is assigned a roster that reflects its expected availability. This ensures the schedule accurately models equipment-level constraints and avoids overcommitting machinery.

Effect on scheduling

A resource’s roster directly determines its available operating hours. It can only perform scheduled tasks during time blocks assigned to the Available work category.

During Available intervals:

During non-productive intervals:

This ensures that scheduled tasks are only executed during valid operating windows, and downtime is represented.

Example: roster impact on Gantt chart

In the example below, the resource is assigned a roster with Unavailable blocks during certain hours.

A resource’s roster. It’s only available during weekdays.

These blocks appear in the Gantt chart as non-productive tasks, interrupting the scheduled work.

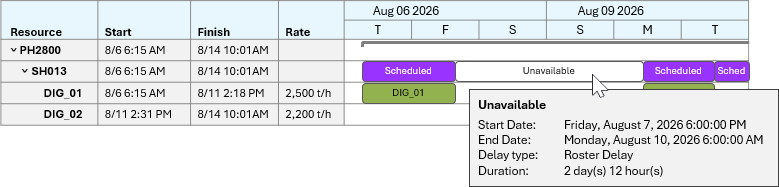

A Gantt chart, showing how a non-productive task interrupts a scheduled task. The task tooltip shows details about the break, such as the start and end time, duration, and work category name.

Roster interval

When configuring a roster, you choose the interval size, which is the granularity of each time block used to assign work categories. This determines how precisely you can define a resource’s operating schedule.

Available interval sizes:

Work category assignments are proportional across intervals. For example:

Visual example

Let’s say you assign Available from 02:00 to 02:30, and Unavailable from 02:30 to 02:45. When viewed at the 15-minute level, this detail is clearly visible.

But when viewed at the hourly level, the 02:00 block will show Unavailable with a “!” icon to indicate that only part of the hour is actually unavailable.
